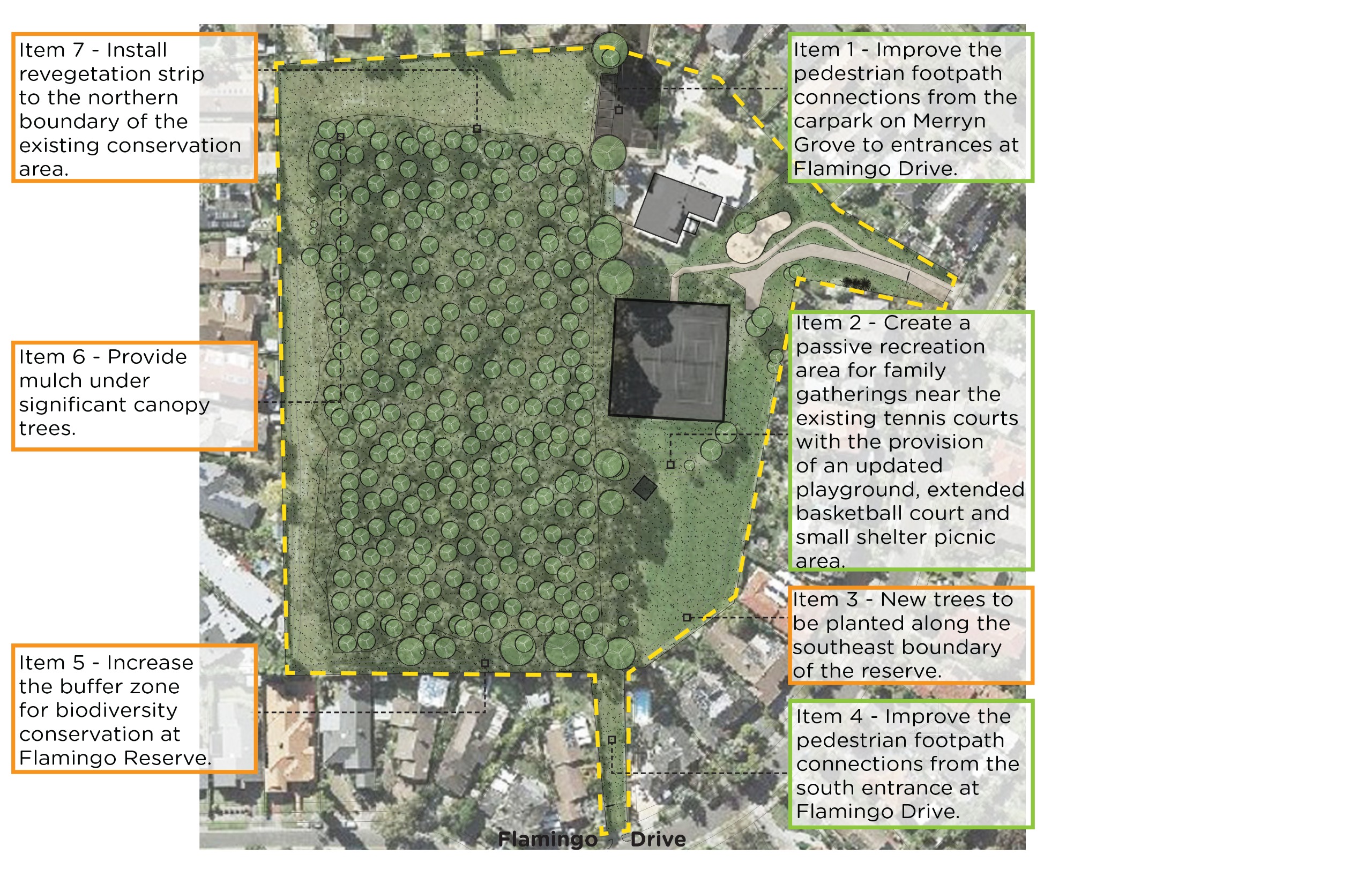

Final Landscape Plan
Thank you for your feedback on the Flamingo Reserve Landscape Plan. Your input has shaped the final plan that will help to improve the park for the community now and into the future.
Next steps
Detailed design work on the new reserve features such as the playground, picnic shelter, solar lighting and footpath network will commence and be completed by June 2024.
A staged delivery of construction works will follow and take place over the next 5 years subject to the allocation of future Council budget.
The development of the Flamingo Reserve Landscape Plan is part of the Knox Capital Works Program and Council’s commitment to upgrade ageing infrastructure. The purpose of the plan is to guide future growth and development and establish a new vision for future use of the reserve.
The Open Space team commenced the Landscape Plan process in July 2021. A background analysis and survey was conducted a review of the reserve attributes, taking into account the existing landscape characters, access, pathways and recreational facilities. Consideration was given to how the reserve functions as a whole and how different elements combine to best provide for our ever-changing and growing community.
The process of creating the Flamingo Reserve Landscape Plan centered around feedback received from relevant stakeholders. The Open Space team worked with internal stakeholders between September to December 2021 to ensure other related Capital Works Program projects were incorporated into the development of the plan. Consultation with the community took place in February and August 2022. The input provided helped to identify the key elements the community felt would improve the park now and in to the future.
All feedback received has been under review and used by the Open Space team to finalise the Landscape Plan.
Timeline
-
Timeline item 1 - complete
February to March 2022
Gather initial feedback
-
Timeline item 2 - complete
April - June 2022
Review feedback and develop draft landscape plan
-
Timeline item 3 - complete
August - December 2022
Second round of community consultation and completion of final Landscape Plan
-
Timeline item 4 - incomplete
July 2023
Commence the detailed design
-
Timeline item 5 - incomplete
July 2024 - June 2025
Landscape Plan Implementation Stage 1* - Delivery of new path network. New solar lighting and additional seating. (*Subject to future budget process)
-
Timeline item 6 - incomplete
July 2025 - June 2026
Landscape Plan Implementation Stage 2* - Delivery of new family gathering area including basketball shooting key area extension, new playspace and picnic area. (*Subject to future budget process)
Document Library
Contact us
If you have any questions or want to learn more about this project, please contact us below:
Name | Open Space and Landscape Design Team |
---|---|
Phone | 9298 8782 |
openspace@knox.vic.gov.au |
